Discussion about this post

User's avatar
Daniel Oliveira's avatar

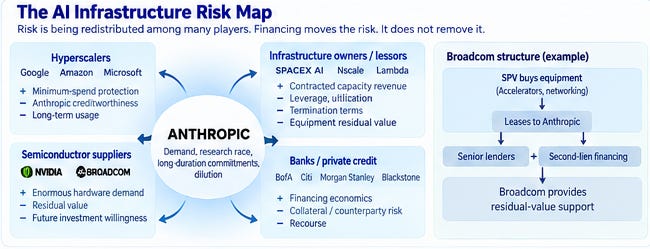

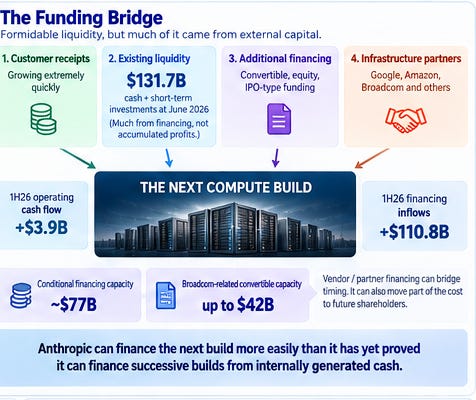

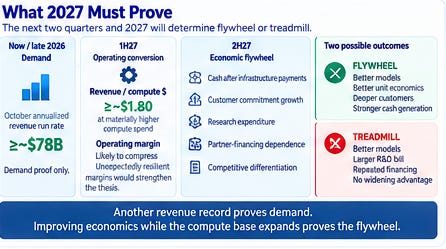

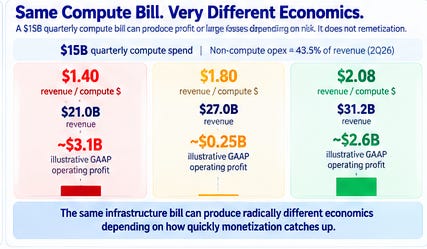

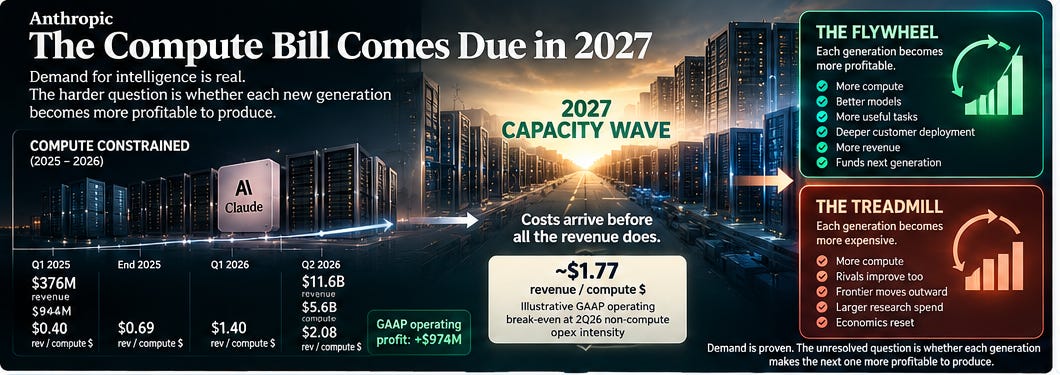

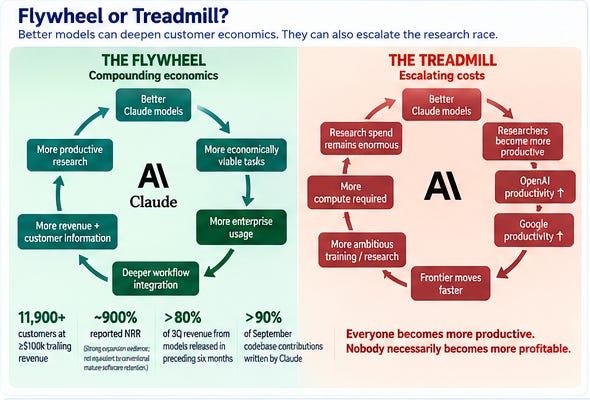

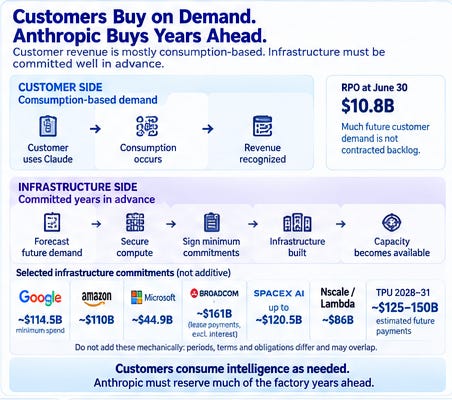

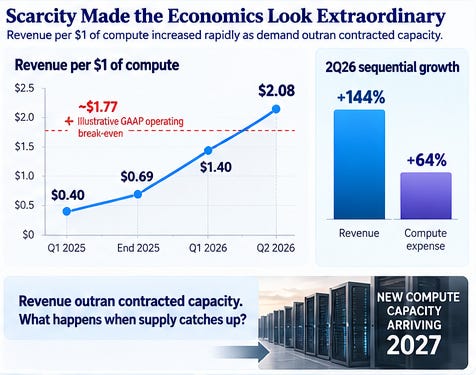

One timing detail in the S-1 supports your 2027 framing. Broadcom rent usually starts when racks are "ready for service," but the S-1 adds that it "may commence earlier in certain circumstances, such as when the readiness of a data center facility is delayed." And the draw period on the up-to-$42 billion of notes Anthropic can issue Broadcom to pay that rent only begins once the first equipment is ready for service (it hadn't started at June 30). So a delay can put the bill ahead of the capacity and, for the first racks, ahead of the financing meant to cover it too.

I work at Equibles and checked the S-1's compute agreements against the partners' own filings: https://equibles.com/research/anthropics-s-1-checked-against-amazon-google-microsoft-and-broadcom-filings
